Realities of Erecting Tensile Sports Structures on Site

5 Mins Reading
Proper tensioning is an exact science. What local installation crews must know about pulling membranes to engineering tolerances without damaging the hardware.

“`html

A sports installation involves distinct phases: foundation work, steel erection, and membrane tensioning. Each phase demands specific skills and coordination. This guide clarifies what Jutent Engineering, as the manufacturer, provides and what your site team needs to prepare and execute for a successful sports installation. Understanding these responsibilities upfront ensures a smooth project timeline and avoids costly delays.

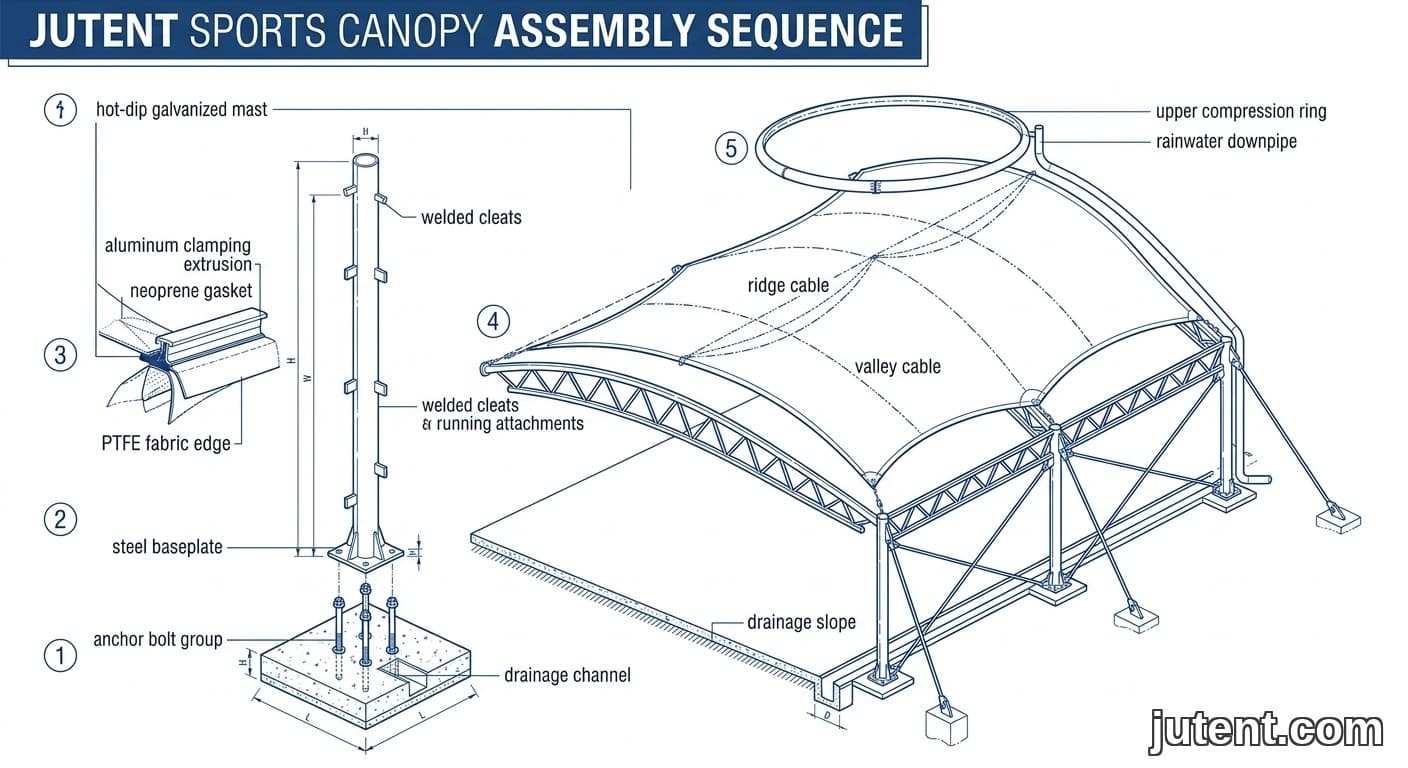

Labeled technical diagram showing exploded cross-section of a tensile sports canopy: foundation, steel mast, PTFE membrane clamping and drainage.

The Four Phases of a Tensile Canopy Installation

A sports installation is a structured process, typically broken down into four critical phases. Each phase builds upon the previous one, requiring precise execution and adherence to engineering specifications. The initial phase involves preparing the ground and establishing a stable base for the structure. This is followed by the assembly and erection of the primary support framework. Once the steel structure is secure, the architectural membrane is carefully installed and tensioned to achieve its designed form and structural integrity. Finally, the project concludes with final adjustments and site cleanup. Based on Jutent's experience across 400+ projects in 30+ countries, meticulous planning for each phase is paramount for project success and long-term durability. Understanding these phases helps contractors allocate resources effectively and coordinate with the manufacturer. For more information on specific designs, visit our Sport Court Shade page.

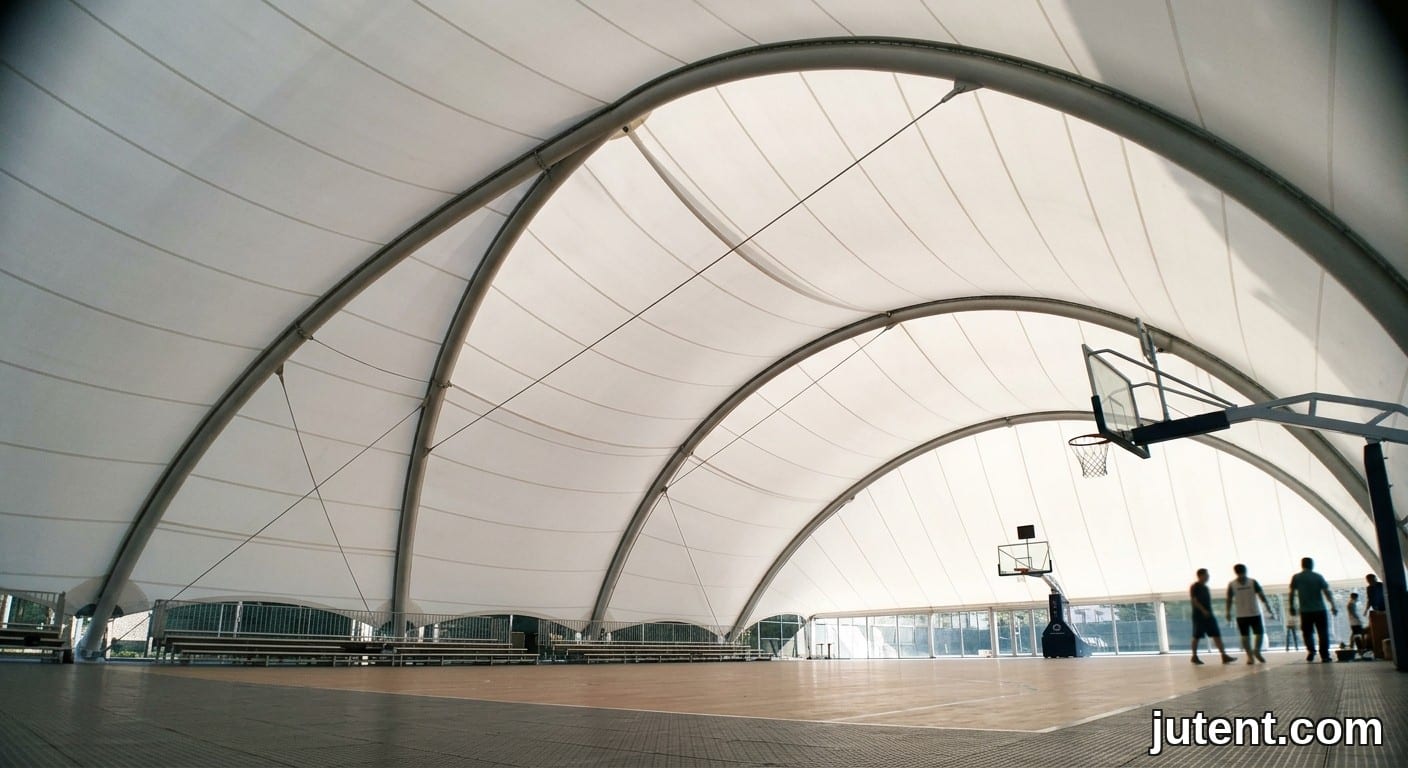

Looking up at a smooth PTFE membrane roof over a basketball court, supported by steel arches, natural daylight diffusing through.

Foundation Work: What Your Civil Team Needs to Complete Before Delivery

The success of any sports installation hinges on reliable foundation work. This phase is entirely the responsibility of your civil engineering team and must be completed well in advance of the steel structure's arrival on site. Jutent provides thorough foundation drawings, including anchor bolt layouts, loads, and rebar schedules, which your team will use to construct the concrete footings. These drawings specify the exact dimensions, depth, and reinforcement required to withstand the design wind loads and membrane tension forces. Typical foundation types include isolated pad footings or strip footings, depending on the canopy's size and design. It is crucial that anchor bolts are cast precisely according to the provided templates, ensuring correct alignment and projection for the steel columns. Any deviation can lead to significant delays during steel erection. Proper curing time for concrete must also be observed before any structural loads are applied. This preparation is non-negotiable for the structural integrity of the entire tensile canopy. For a deeper dive into design considerations, refer to our comprehensive guide to tensile shade structures for sports courts.

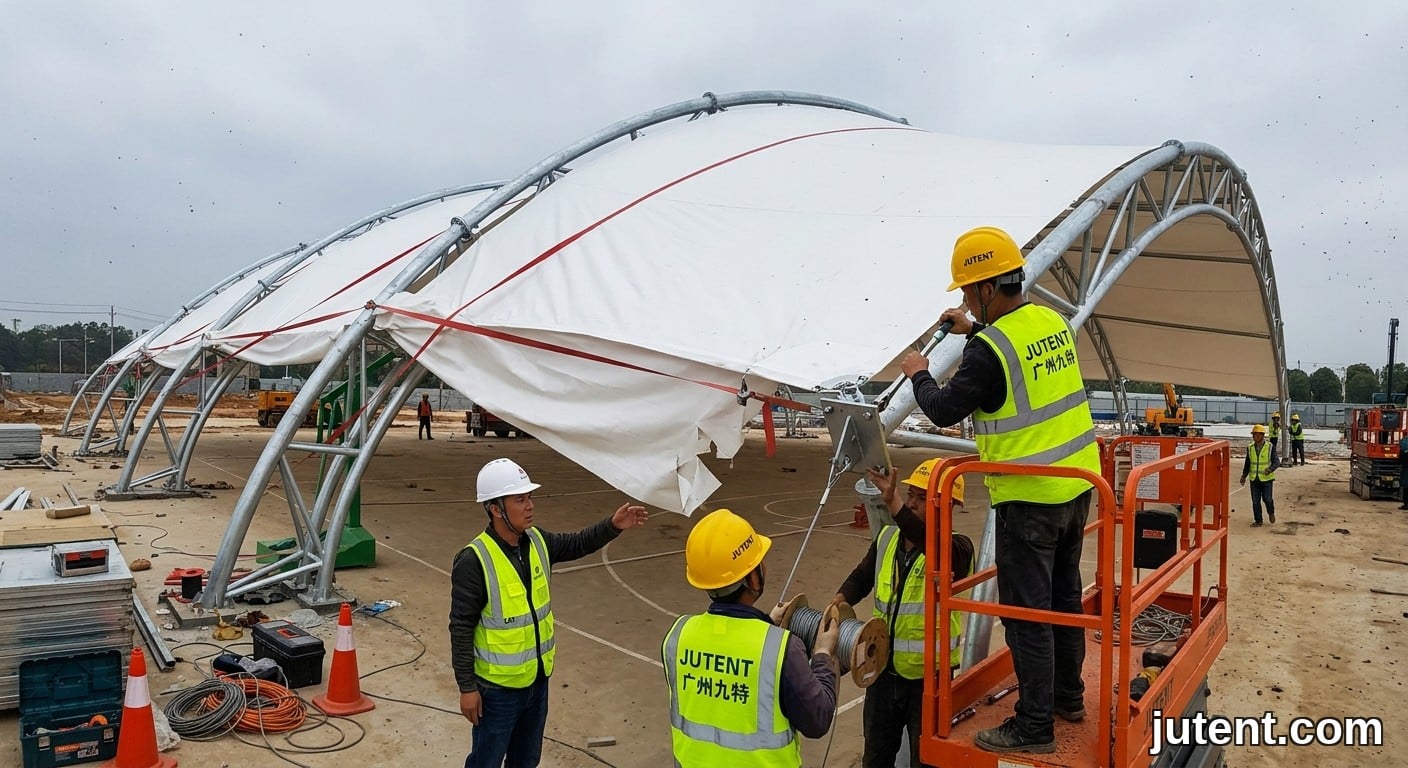

Mid-installation of a sports tensile canopy, workers in JUTENT vests and yellow helmets tensioning white membrane over steel masts.

Steel Structure Erection: What Arrives Flat-Pack and How It Goes Together

The steel structure for a sports installation arrives at your site in a flat-pack format, optimized for efficient shipping and assembly. This typically includes columns, beams, trusses, connection plates, and various bracing elements. All steel components are fabricated from high-grade Q235B or Q355B steel (US/EU equivalents such as ASTM A36 or ASTM A572 Grade 50 are available on request), prepared with an epoxy zinc-rich primer and either an acrylic or fluorocarbon topcoat for corrosion resistance. Each component is pre-drilled and marked according according to the assembly drawings provided by Jutent. Your site team will be responsible for offloading, sorting, and assembling these components using cranes, lifting equipment, and standard construction tools. The erection sequence generally involves setting the main columns onto the pre-cast anchor bolts, followed by connecting horizontal beams and purlins. Connections are typically bolted, requiring precise alignment and torqueing to specified values. Safety protocols for working at height and lifting heavy loads are paramount during this phase. Detailed erection drawings and a bill of materials are supplied to guide your team through the entire assembly process.

Membrane Installation: Tensioning Sequence and Common Mistakes

The membrane installation is a critical phase of the sports installation, transforming the steel frame into a functional and aesthetically pleasing structure. Jutent typically supplies 1050 g/m² PVDF or PTFE membrane, pre-fabricated into panels w
“`
